Original Source Documents:    August 1, 1938 - 451 (Development) - Progress Report - Month Ending July 31, 1938 - Project EDT - No. 29-8 - Truck, Chassis, 4-wheel drive, Quarter-ton Capacity (Carrier - Machine Gun)    details
Contributor:    Todd G. Paisley
Source:    National Archives - Philadelphia

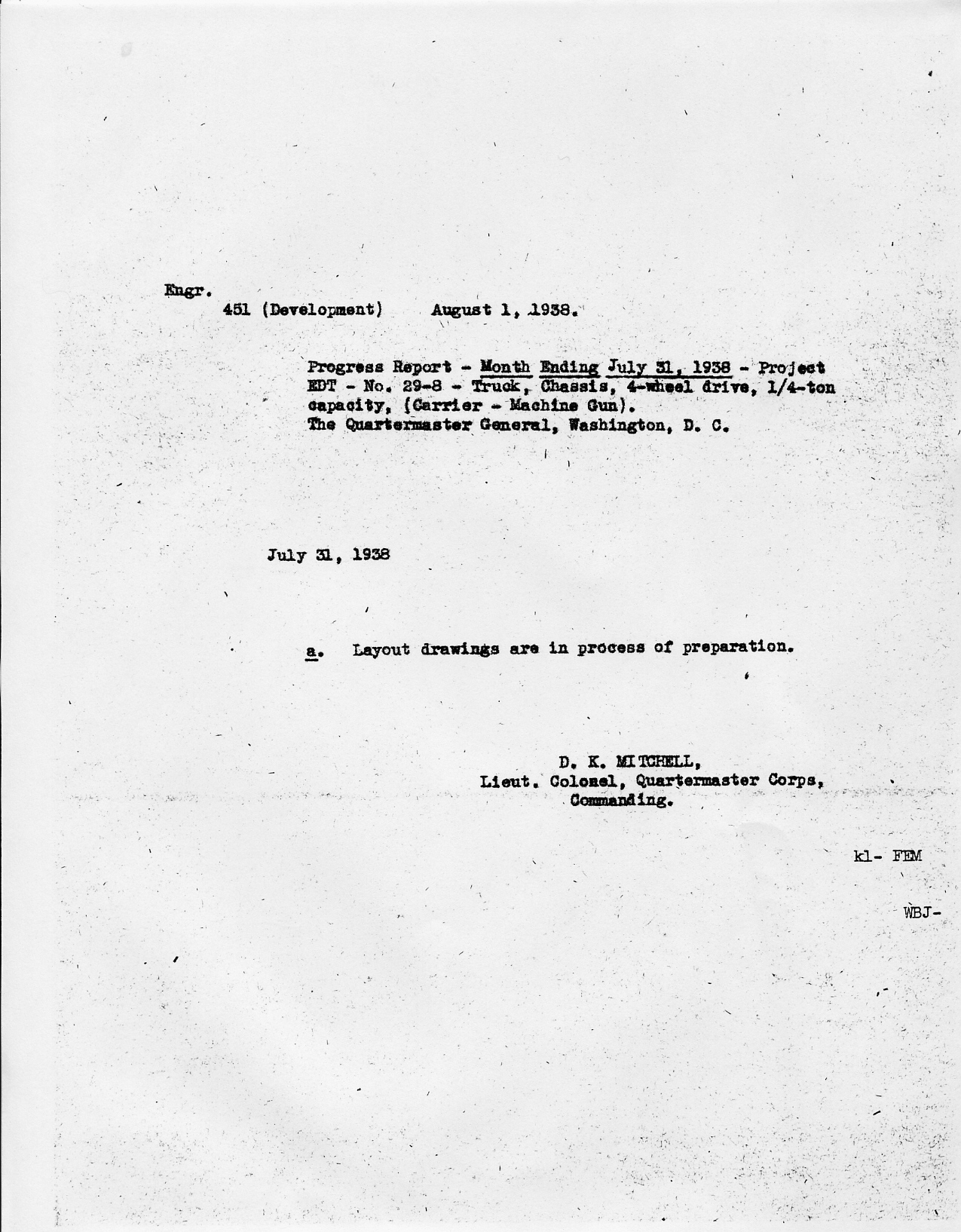

HEADQUARTERS
HOLABIRD QUARTERMASTER DEPOT
BALTIMORE, MARYLAND

Engr. File: 451 (Development)

August 1, 1938

SUBJECT:     Progress Report - Month Ending July 31, 1938 - Project EDT - No. 29-8 - Truck Chassis, 4-wheel drive, 1/4-ton capacity (Carrier - Machine Gun)

TO:     The Quartermaster General, Washington, D. C.

July 31, 1938

a. Layout drawings are in process of preparation.

D. K. MITCHELL,
Lieut. Colonel, Quartermaster Corps,
Commanding.

K1 - FEM

WBJ
